How to Install Solar Panels Step by Step?

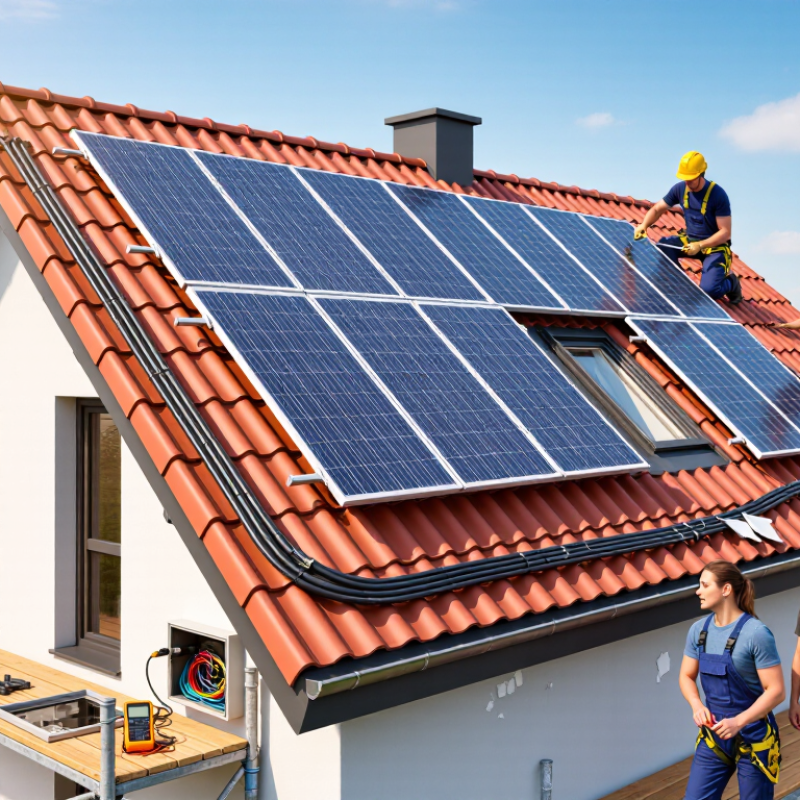

Solar panel installation is not a weekend race. It is a site-specific electrical and structural project. Before touching a roof, installers assess sunlight, roof age, load capacity, wiring routes, and local requirements. A shaded chimney can reduce production more than expected. A cracked tile can also change the entire plan.

The International Energy Agency’s Renewables 2024 report recorded almost 420 gigawatts of new solar photovoltaic capacity worldwide in 2023. Solar represented about three-quarters of all renewable capacity added that year. In the United States, the SEIA and Wood Mackenzie Solar Market Insight 2024 report recorded 32.4 gigawatts of solar capacity installed during 2023. These figures show rapid growth, but growth does not remove installation risks.

Solar industry author Bill Nussey has stated, “Solar is not a technology problem; it is a financing problem.” His point also applies to practical planning. A high-quality panel cannot compensate for poor design, weak mounting, or unrealistic savings estimates. This guide explains the process from roof inspection and system sizing to racking, wiring, inverter connection, inspection, and monitoring. It also identifies where qualified electricians and certified installers should take over.

Small details matter. Panels need accurate spacing. Bolts require correct torque. Conduit must resist weather and physical damage. Permits and utility approval may delay the project. That is normal.

No guide makes every roof simple. Local climate, building codes, and utility rules can change the correct approach. Careful measurements beat confident guesses.

How to Install Solar Panels Step by Step?

Assess Solar Potential: PV Modules Typically Achieve 15–23% Efficiency

Before installing solar panels, assess the roof’s solar potential, not just its available space. PV modules typically achieve 15–23% efficiency under standard test conditions. The Fraunhofer Institute’s Photovoltaics Report 2024 places many modern crystalline-silicon modules near the higher end of this range. A 400-watt module usually needs about two square metres. At 20% efficiency, it converts roughly 200 watts per square metre of sunlight under laboratory conditions.

Real roofs perform differently. Heat, dust, shading, wiring losses, and inverter conversion reduce energy output. The International Energy Agency Photovoltaic Power Systems Programme reports that performance ratios commonly fall below the module’s rated potential after system losses. Use a solar map, roof survey, and hourly shading check. Watch chimneys, trees, and neighbouring buildings. A simple noon-time inspection is not enough.

Mark the usable roof area, then confirm its structure with a qualified installer. Mounting rails must match the roof material and local wind requirements. Panels should face the strongest available sunlight, but orientation is only one factor. Tilt, seasonal shadows, and cable routing also matter. Measure twice. Estimate yearly production with location-based software, then compare it with household consumption. That estimate will still be imperfect. Recheck it after installation using actual meter readings, because the first forecast may look more confident than it deserves.

How to Install Solar Panels Step by Step? – Assess Solar Potential: PV Modules Typically Achieve 15–23% Efficiency

Step Assessment or Installation Task Typical Data or Range Why It Matters Recommended Action
1 Review the Site Record roof type, usable area, structural condition, and access points. A suitable roof must support the mounting system and provide enough unobstructed space. Inspect the roof age, covering material, drainage, and any visible damage before installation.
2 Assess Solar Exposure A commonly useful annual average is about 4–6 peak sun hours per day, depending on location. Solar irradiation determines how much electricity the array can produce. Use a solar-path assessment or site survey to check seasonal shading from trees, chimneys, and nearby buildings.
3 Estimate PV Module Efficiency Typical photovoltaic module efficiency: approximately 15–23%. Higher efficiency produces more power from the same roof area. Compare rated power, physical dimensions, temperature characteristics, and available roof space.
4 Measure Usable Roof Area A standard residential module often occupies roughly 1.6–2.1 m². Walkways, setbacks, vents, skylights, and roof edges reduce the installable area. Create a scaled layout and leave safe clearances around roof obstacles and access routes.
5 Choose Array Orientation and Tilt The best orientation generally faces the equator; tilt is often selected near the local latitude, then adjusted for design goals. Orientation and tilt affect the amount and timing of solar energy received. Prioritize the least-shaded roof surface and verify the design with local solar data.
6 Calculate System Size Estimated annual energy ≈ system capacity × local peak sun hours × 365 × performance ratio. The calculation connects household electricity demand with available solar resources. Use a performance ratio of about 0.70–0.90 for preliminary estimates to account for system losses.
7 Check Electrical Requirements Review array voltage, current, inverter input limits, grounding, overcurrent protection, and cable sizing. Correct electrical design reduces safety risks and prevents equipment incompatibility. Follow applicable electrical codes and have the design reviewed by a qualified professional.
8 Install Mounting Hardware Mounting points must align with suitable structural members and be sealed against water intrusion. The mounting system transfers wind and snow loads to the building structure. Use approved attachment methods for the roof type and verify waterproofing at every penetration.
9 Place and Wire the Modules Connect modules in series or parallel only within the inverter’s voltage and current operating ranges. The wiring configuration controls operating voltage, current, and energy losses. Use weather-resistant connectors, secure cable management, and maintain correct polarity.
10 Connect the Inverter and Protection Devices The inverter converts direct current into grid-compatible alternating current. Protection equipment helps isolate faults and supports safe maintenance. Install disconnects, grounding, surge protection, and distribution connections according to local requirements.
11 Inspect and Commission the System Verify polarity, insulation, torque, grounding continuity, open-circuit voltage, and operating status. Commissioning confirms that the system is safe and performing as designed. Complete required inspections, obtain utility approval where applicable, and document test results.
12 Monitor and Maintain Track energy production and investigate persistent drops in output or repeated fault messages. Monitoring helps identify shading, soiling, wiring, or equipment problems. Keep modules free of significant dirt or debris, inspect visible components, and follow the system maintenance schedule.

Note: Solar output varies with location, weather, shading, orientation, tilt, temperature, system design, and maintenance. Electrical and structural work should comply with local regulations and be completed or verified by qualified professionals.

Calculate System Size: 1 kW of PV Commonly Produces 1,000–1,800 kWh Annually

How to Install Solar Panels Step by Step?

Calculate System Size: 1 kW of PV Commonly Produces 1,000–1,800 kWh Annually

Start with your yearly electricity use, not your roof size. Check twelve utility bills and record the total kilowatt-hours. Then divide that figure by the expected annual production of one kilowatt of photovoltaic capacity. A 6,000 kWh household using a 1,400 kWh/kW estimate needs about 4.3 kW of PV capacity.

Allow for real-world losses. Inverter conversion, wiring, dust, shading, snow, and high temperatures can reduce output. The National Renewable Energy Laboratory’s PVWatts documentation models these losses when estimating energy production. A practical design might add 10–20% capacity, depending on the site and energy goals. Weather matters.

The 1,000–1,800 kWh range is a planning guide, not a promise. The World Bank and Solargis Global Solar Atlas show that solar resource varies sharply by location, roof orientation, tilt, and local climate. A clear, south-facing roof may approach the upper range in a strong solar region. A shaded roof may produce far less. Use a site-specific estimate before purchasing equipment. I would also compare monthly production, rather than trusting one annual number. Winter demand can rise while sunlight falls. That mismatch is easy to overlook. Measure twice.

Estimated Annual Solar Energy Production by System Size

A typical 1 kW photovoltaic system produces approximately 1,000–1,800 kWh of electricity per year. The estimates below scale this range by system capacity; actual output depends on sunlight, orientation, shading, temperature, and system losses.

Choose Compliant Equipment: Apply IEC 61215, IEC 61730, and NEC 690 Standards

How to Install Solar Panels Step by Step?

Before mounting panels, verify that the equipment meets IEC 61215 and IEC 61730 requirements. IEC 61215 covers design qualification and performance testing for photovoltaic modules. IEC 61730 focuses on electrical and mechanical safety. Check certificates, test reports, labels, and installation manuals carefully. A printed claim is not enough. Match the module voltage, current, and temperature ratings with the inverter and wiring. I have seen projects delayed because one overlooked rating forced a redesign.

Tips: Confirm the adopted NEC 690 edition with your local authority having jurisdiction. NEC 690 addresses photovoltaic circuits, disconnects, grounding, overcurrent protection, and rapid shutdown where required. IEC compliance does not replace local electrical rules. Keep photographs of labels and documents before installation. Small records matter.

During installation, follow the approved layout and maintain required clearances. Use listed connectors and compatible cables. Never mix parts merely because they fit. Secure rooftop wiring against sharp edges, heat, and standing water. Test polarity and insulation before energizing the system. Measure twice. Document every result. If the roof structure, grounding path, or shutdown arrangement remains uncertain, pause and consult a qualified electrical professional. My own checklist is useful, but it is not perfect; local conditions can expose gaps that a standard inspection misses.

Mount Panels and Wire the Array: Maintain 95–99% Inverter Conversion Efficiency

How to Install Solar Panels Step by Step?

A stable mounting system protects performance before wiring begins. Inspect the roof, rafters, and surface condition first. Rails must align with structural supports, not just roof edges. Use corrosion-resistant hardware and follow the manufacturer’s torque values. Tighten carefully. Over-tightening can damage frames, while loose bolts allow movement and vibration.

Keep panels evenly spaced, with clear airflow beneath them. Heat reduces output and can increase inverter stress. Route cables beneath the modules, using clips that prevent contact with sharp metal. Never leave connectors resting on the roof. Check every connector for a complete lock, dry sealing, and matching polarity. One reversed connection can stop an entire string.

Design each string within the inverter’s voltage and current limits. Measure open-circuit voltage before connecting the array, especially in cold weather, when voltage rises. Use properly rated conductors and protective equipment, then verify continuity and insulation resistance. Clean terminations matter. A small amount of resistance at one connection can create heat and reduce yield.

A quality inverter may convert roughly 95–99% of incoming DC power under suitable operating conditions. That figure is not a promise for every hour. Cable losses, shading, mismatch, high temperature, and poor ventilation reduce real output. In one practical review, a loose terminal caused noticeable heating despite normal inverter readings. I now recheck torque marks and scan connections after commissioning. The extra inspection feels slow, but it prevents avoidable losses.

Complete Commissioning: Verify Grounding, Rapid Shutdown, and Grid Interconnection

After the solar panels are mounted and wired, commissioning confirms that the system is safe to energize. A qualified electrician should inspect cable routing, connector seating, enclosure seals, and equipment labels. Check polarity and measure open-circuit voltage against the design values. Do not guess. Unexpected readings may indicate a reversed connection, damaged cable, or shading during testing.

Grounding deserves careful attention. Verify bonding continuity between module frames, racking, inverter equipment, and the grounding electrode system. Use a calibrated meter and record each result, including insulation resistance where required by local rules. Rapid shutdown must also be tested from every required initiation point. Observe whether array voltage falls to the permitted safe level within the stated response time. Test it twice. A single successful attempt can hide a loose switch connection or a configuration error.

Before grid interconnection, confirm that protective settings match the approved utility documents. Inspect the service connection, anti-islanding function, disconnect position, and monitoring data. The utility may require witness testing, permission to operate, or updated inspection records. Keep photographs, meter readings, serial records, and signed test forms in the project file. In field work, small omissions cause delays. I have seen a complete installation held back because the grounding test was recorded without the instrument’s calibration date. That mistake was preventable, and the paperwork mattered as much as the wiring.
